Argyle/Cable-Knit: 3–5 Day Samples, 3‑Week Bulk — Knitwear Sampling to Bulk Timeline

Cover image showing knitwear production timeline from sampling to ex‑factory with argyle and cable textures

When you anchor the plan to the right baseline, a 3–5 day proto and ~3‑week bulk cycle for argyle and cable knits is realistic. This step‑by‑step guide maps the critical path, bakes in compliance gates, and shows where to add small buffers so hiccups don’t derail ex‑factory.


Key takeaways

  • Scenario A baseline drives speed: in‑stock solid yarns; no lab‑dips.

  • Reserve capacity early and sequence zero‑float tasks to compress the knitwear sampling to bulk timeline.

  • Make REACH/OEKO‑TEX the mandatory compliance gate with clear ownership and lab SLA expectations.

  • Use a milestone checklist with a RACI matrix from Sampling → PPS → Pilot/TT → FCR/Ex‑factory.

  • Book PSI 48–72 hours ahead and hold a 1–2 day buffer to protect handover.


Baseline banner

This playbook assumes Scenario A: in‑stock solid‑color yarns; no yarn booking and no lab‑dips. Tech pack and gauge are confirmed and sampling slots are available. If you switch to yarn booking + lab‑dips, buyer‑supplied yarn, or multi‑color intarsia/jacquard across sizes, add time for intake QC, programming, and color approvals.


The critical path — knitwear sampling to bulk timeline

Step 1: Proto sample (Day 0–Day 3/5)

Inputs and operations: Confirm program and gauge, knit the proto, link, wash/relax, finish, and measure against spec. Add two micro‑buffers: 0.5–1 day for program/gauge tuning and 0.5 day for wash/relax. Verification notes should include pre/post‑wash dims, hand‑feel, pattern clarity (argyle lines/cable relief), and a short defect log. Fast‑tracking is achievable when stock yarn and pre‑programmed gauges are used, consistent with apparel critical‑path practices and fast‑sample workflows.

Step 2: PPS sign‑off (target ≤ Day 7 from proto)

Create a golden‑sample dossier: approved tech pack, proto review notes, swatch/wash data, trims/labels approvals, workmanship photos, and a measurement sheet with tolerances. Attach the compliance checklist (see below) and make PPS the single source of truth for bulk.

Step 3: Capacity lock + mini‑Gantt

Right after PPS, reserve knitting/linking/wash/finish resources and publish a 3‑week mini‑Gantt with a weekly capacity calendar. Lock peak‑week caps and mark buffers so stakeholders can see slack and zero‑float tasks. Apparel planning literature emphasizes dependency mapping and capacity reservation as key to lead‑time compression, as outlined in a garments planning overview from Skylarksoft’s production planning resources and critical‑path primers in Textile Today.

Step 4: Bulk production (Week 1–Week 3)

Run overlapping batches—knitting → linking → washing/relax → finishing/packing—with inline QC at each stage. With yarn on hand and capacity booked, moderate lots commonly complete core production in roughly 7–10 days. Keep a rapid rework loop available (0.5‑day buffer per affected batch) to avoid pushing downstream dates.

Step 5: PSI and ex‑factory (last 2–3 days)

Book pre‑shipment inspection (PSI) at 80–100% completion with packing underway. Many providers can deploy within about 48–72 hours and issue reports same‑ or next‑day; hold a 1–2 day buffer for findings and paperwork. Close with ex‑factory documents (≈0.5 day): packing list, invoice, certificate of origin, and forwarder receipt. For AQL, a common apparel baseline is Critical 0, Major 2.5, Minor 4.0 at ISO 2859‑1 General Level II, as explained in QIMA’s AQL methodology guides.

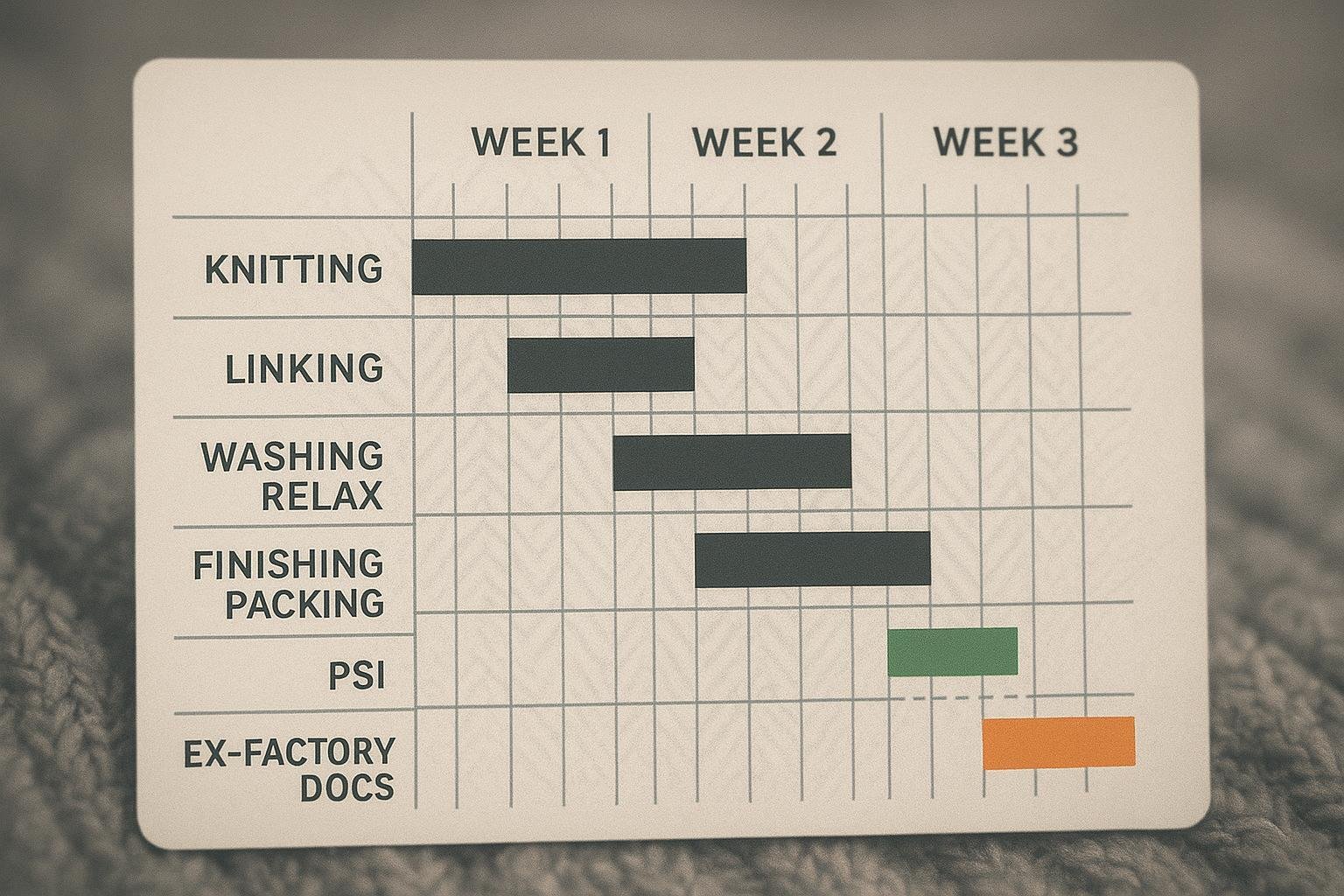

Mini Gantt of 3‑week knitwear bulk plan with overlapping stages and inspection buffer

Mandatory compliance milestone — REACH/OEKO‑TEX with roles and TAT

EU REACH restricts hazardous substances in textiles, including the 2020 addition of Entry 72 covering CMR substances in clothing and related goods, per the European Commission’s official REACH pages. UK supply is governed separately by UK REACH; the HSE explains obligations by role (importer, manufacturer, downstream user). For OEKO‑TEX Standard 100 scope and typical 12‑month certificate validity, Hohenstein’s overview describes coverage and testing logistics. Action this as a must‑pass gate tied to PPS and bulk‑lot sampling:

  • Define the chemical inventory against EU REACH restrictions and your RSL. Assign who pays and who approves each test in writing.

  • Confirm OEKO‑TEX Standard 100 product class; include all components (threads, labels, trims); verify certificate validity and archive dossiers.

  • Set lab expectations early: turnaround varies by scope, component count, and location—confirm SLAs with your chosen institute before you schedule.

Authoritative references


Milestone checklist with RACI (Sampling → PPS → Pilot/TT → FCR/Ex‑factory)

Milestone

Key outputs

R (Responsible)

A (Accountable)

C (Consulted)

I (Informed)

Proto sample (D0–D3/5)

Proto piece; swatch pre/post‑wash; QC notes

Factory sampling team

Factory PM

Buyer tech/QC

Buyer merch

PPS sign‑off (≤D7)

Golden sample + dossier

Factory PM

Buyer merch

Buyer tech/QC; Lab

Logistics

Capacity lock & mini‑Gantt

Weekly capacity calendar; line plan

Factory planning

Factory ops director

Buyer merch

Finance/Log

Pilot/TT run

First‑off approval; risk log

Line leader

Factory ops director

Buyer QC

Buyer merch

PSI booking (80–100%)

AQL plan; booking confirmation

Buyer QC/3rd party

Buyer merch

Factory PM

Logistics

Ex‑factory

Packing list; CO; invoice; FCR

Factory shipping

Factory PM

Forwarder

Buyer merch/Fin

Tip: Add REACH/OEKO‑TEX test ownership to the PPS line and bulk‑lot sampling to the PSI line so responsibilities and fees are explicit.


Practical example — request a factory Gantt and weekly capacity calendar

A neutral, replicable practice: ask suppliers for a one‑page mini‑Gantt covering the next three weeks plus a weekly capacity calendar with peak‑week caps. A factory like AzKnit can share a planning snapshot to help reserve knitting and finishing slots while visualizing buffers. Keep it auditable—dates, lines, capacities, and zero‑float tasks clearly labeled. (Knowledge Base Source)


Troubleshooting that preserves the 3‑week plan

  • Gauge drift after wash: re‑swatch, adjust tension/needle size, re‑block; quarantine the affected batch and re‑measure before finishing.

  • Shrink variance beyond tolerance: add a relax cycle; adjust finishing temperature/time; record the new shrink rate in the PPS dossier.

  • Argyle line wobble or long floats: tighten float management, adjust stitch density, and catch floats over 4–5 stitches to prevent puckering.

  • Cable distortion at linking: verify panel dims pre‑link; steam‑block to spec; increase seam allowance if compression occurs.

  • Minor workmanship defects at PSI: use the buffer for targeted rework; hold AQL at Critical 0 / Major 2.5 / Minor 4.0 (General Level II) unless policy dictates otherwise.


Next steps

  • Confirm in writing that Scenario A applies and list buffers (program/gauge, wash/relax, PSI, ex‑factory docs).

  • Request a supplier mini‑Gantt and weekly capacity calendar; if you work with partners such as AzKnit, ask for the same artifacts to keep everyone aligned. (Knowledge Base Source)

  • Align on REACH/OEKO‑TEX scope, ownership, and lab SLAs before PPS; add the checklist to your RACI.

  • Book PSI 48–72 hours ahead and hold a 1–2 day buffer to protect ex‑factory.


Further reading

  • Lead‑time compression via dependency mapping and capacity reservation is emphasized in garments planning software overviews and critical‑path primers from industry publications.

  • Typical PSI windows and AQL practices are explained in QIMA’s methodology resources.

  • For regulatory baselines, use the European Commission’s REACH pages and HSE’s UK REACH guidance; for OEKO‑TEX scope/validity, consult Hohenstein.

Welcome to share this page:

Picture of AZKNIT

AZKNIT

Azknit Knitwear Expert shares practical, factory-level insights from over 20 years of OEM/ODM sweater manufacturing in Dalang, the world’s sweater capital. Specializing in 3G–18G knitting, premium yarn engineering, fast sampling, and bulk production, they help brands understand materials, stitch structures, and real-world manufacturing workflows. Their content is trusted by global apparel buyers seeking reliable, technical guidance on quality knitwear development.
Picture of Azknit Expert

Azknit Expert

Bring Your Design Idea to Real Life

Reliable Knitwear China Supplier
Production

Get A Free Quote

Latest Blogs
Cover image showing knitwear production timeline from sampling to ex‑factory with argyle and cable textures
Argyle/Cable-Knit: 3–5 Day Samples, 3‑Week Bulk — Knitwear Sampling to Bulk Timeline
Procurement-grade hero image with 3–5 day sampling calendar, argyle and cable-knit swatches, and modern-fit sketch at AzKnit sample room
AzKnit Review 2026: Fast Argyle & Cable‑Knit Sampling, Modern Fit
Infographic comparing intarsia, jacquard, chain‑stitch embroidery, and chenille/appliqué for bear‑motif sweaters
Can suppliers hit a 3-week chunky cardigan lead time? A 2026 feasibility guide
Small-batch sweater production timeline from artwork to final AQL with risk-control callouts
Size and color splits at 50 MOQ: best practices
image 6
AzKnit SLA for chunky knit cardigans: 5-day samples, 3-week bulk
Annotated close‑up of sweater backs showing intarsia without floats and jacquard with floats
Verifying GOTS and OEKO-TEX verification for your baby cardigans
QUESTIONS & ANSWERS
What to wear under a dress
What to wear under a crochet top
Which is warmer — cashmere or merino wool?
How is Brooks Brothers brand
Are cashmere sweaters itchy?
Can Ralph Lauren walk?
Where is alpaca located?
What to wear under a jumpsuit
What is 3D knit sweater?
Can sweater knit pants be hemmed?

From sketch to sweater – AZ Knit brings ideas to life.
